Budget overruns are common in software projects. A study by McKinsey and the University of Oxford found that 45% of software development costs exceed their budget, a third run past the original schedule, and nearly 1 in 5 reach a point where they threaten the company’s financial position.
That risk starts with a bad estimate.
Software development cost estimation is the process of calculating how much time and money a project will require, based on scope, team size, tech stack choices, and risk. Early estimates are intentionally rough. They sharpen as requirements solidify. The two variables that matter most at the start are total build cost and time to delivery.
Two questions tend to define whether a project starts on solid footing: how much will this cost, and how long will it take? Early in the process, neither has a clean answer. The scope is still loose, decisions have not been made, and too many things are unknown to give a number you can hold anyone to. That changes as the work gets defined. Each decision that gets made narrows the range, and at some point, those rough estimates become a real budget.
This guide walks through a structured way to assess software development costs, including real scenarios, the factors that move the number, and how to build an estimate you can actually use.
What Does It Cost to Build Software?
Software development costs typically range from $5,000 for a simple MVP to over $300,000 for a full enterprise platform. The final number depends on three variables above everything else: the scope of what you’re building, the complexity of the technical architecture, and where your development team is located. At DistantJob, we help companies hire remote developers who reduce costs without compromising output quality.
| Project Type | What It Usually Covers | North America (est.) | Offshore / Nearshore (est.) | Typical Savings |
| Simple / MVP | Single-feature app, basic backend, limited integrations | $25K–$50K | $5K–$20K | 50–70% |
| Mid-size | Multi-feature product, custom UI, third-party integrations | $80K–$150K | $50K–$90K | 30–50% |
| Enterprise | Complex architecture, multiple integrations, compliance needs | $200K–$300K+ | $100K–$180K+ | 30–45% |
Here are a few notes on these ranges. They assume a standard team composition (one to three developers, a PM, and a QA role depending on project size). Your number depends on whether you’re hiring freelancers, building an in-house team, or using a distributed model.
North America rates reflect senior developer salaries in the $120–$180/hr consulting range. Nearshore and offshore figures are based on equivalent seniority in Latin America, Eastern Europe, and Southeast Asia.
The ranges overlap intentionally. A mid-size project with a lean remote team can land closer to MVP pricing. An MVP with complex compliance requirements can push into enterprise territory.
Why Software Cost Estimates Are So Unreliable
Software is not a manufacturing process. There is no fixed blueprint, no predictable assembly line, and no guarantee that what you plan in month one matches what you build in month six.
The numbers reflect this. McKinsey found that 45% of enterprise software projects exceed their original budget. BCG puts the problem in sharper terms: two-thirds of large-scale tech programs fail to deliver on time, within budget, or within the agreed scope, with individual project failures sometimes exceeding $23 million in losses.
Four patterns drive most of those overruns:
1. Shifting requirements
Scope changes mid-build are the single most common cause of blown budgets. What the client wants in week two is rarely what they wanted in week one.
2. Integration complexity
Connecting your product to third-party systems, APIs, or legacy infrastructure almost always takes longer than estimated.
3. Team velocity variance
Developer output is not consistent. Onboarding time, communication overhead, and skill gaps all compress what teams can realistically ship per sprint.
4. Post-launch underbudgeting
Most estimates stop at delivery. Maintenance, bug fixes, and iteration cycles routinely add 15–20% to the total cost in year one alone.
The goal is not a perfect estimate. It is a continuously corrected one.
How to Estimate Software Development Costs: A 7-Step Framework
Estimating software development costs is a challenge, but certain methods and techniques can make the process more precise. Instead of trying to cut costs to appease investors and executives, the goal is to obtain a realistic, data-driven estimate that supports planning and decision-making.
Step 1: Requirements and Scope
Before any number makes sense, you need a clear picture of what you are building. Two approaches dominate here.
First, Waterfall. Waterfall projects use a Work Breakdown Structure (WBS): a hierarchical decomposition of every deliverable, task, and dependency mapped out before development begins.
In contrast, Agile projects use a product backlog instead, organized into epics (large functional areas) and user stories (specific features or behaviors).
Waterfall gives you a fixed scope to estimate against. Agile gives you a living document that improves your estimates over time.
Neither is wrong. The method you choose should match how your project demands. If your project has a small scope and its requirements are clear from the start, the Waterfall is the best choice. But if the scope is undefined and your customer wants to give their feedback often, Agile will help you in many ways.
Step 2: Utilize Multiple Estimation Techniques
No single estimation method fits every project. The right choice depends on how much information you have at the time of estimating.
| Method | How It Works | Best For | Accuracy |
| Analogy | Compares the project to a similar past project | Early-stage estimates when the scope is loose | Low–Medium |
| Parametric | Uses statistical models based on project variables | Projects with reliable historical data | Medium |
| Bottom-Up | Estimates each task individually, then sums them | Detailed scopes with defined deliverables | High |
| COCOMO II | An algorithmic model based on lines of code and cost drivers | Large or complex enterprises build | Medium–High |
| Function Point Analysis (FPA) | Measures functional size based on inputs, outputs, and files | Compliance-heavy or legacy system projects | High |
COCOMO II was built for the waterfall era but remains useful for enterprise projects where you can quantify scale. For most modern Agile teams, bottom-up estimation with sprint-level breakdowns gives you more actionable numbers.
Step 3: Break the Work into Epics or Tasks
Bottom-up estimation works by pricing each piece of work individually, then adding everything up. Start by listing your features, break each one into tasks, and assign a time estimate to each task. From there, the cost calculation is straightforward.
The DECODE formula

Worked example: A user authentication feature (registration, login, password reset) is estimated at 5 days of work. Two developers handle it at $75/hr each.

Run this across every feature in your backlog, and you have a bottom-up project estimate grounded in actual planned work, not guesswork.
Step 4: Calculate Sprint Costs
Once your work is broken into tasks, sprint costing gives you a repeatable unit of budget planning. A sprint is a fixed development cycle, typically one or two weeks, with a defined team working toward a set of deliverable stories.
Formula:

Worked example: A 2-week sprint with 4 developers at an average blended rate of $60/hr:

A project scoped for 8 sprints at this rate carries a development cost of approximately $153,600 before any non-coding phases are factored in. Mapping sprint costs to your backlog gives you a budget that moves with the project rather than one set in stone at kickoff.
Step 5: Add Phase Costs Beyond Coding
Development is rarely more than 60–70% of what a project actually costs. The phases that surround it are where budgets quietly expand.
| Phase | Typical Cost Range | % of Total Build Cost |
| Discovery & Requirements | $3,000–$15,000 | 5–10% |
| UI/UX Design | $5,000–$30,000 | 8–15% |
| Development | Varies by scope | 50–65% |
| QA & Testing | $5,000–$25,000 | 10–15% |
| Deployment & DevOps Setup | $2,000–$10,000 | 3–7% |
| Documentation | $1,000–$5,000 | 1–3% |
Teams that skip or underbudget discovery tend to pay for it in rework. A poorly scoped project that skips upfront design and QA allocation will almost always cost more in total than one that funds those phases properly from the start.
Step 6: Budget for Post-Launch
Most project budgets end at go-live. That is where many cost surprises begin. A live product requires ongoing investment across three areas.
Maintenance typically runs 15–25% of the original build cost per year. For a $100,000 project, expect $15,000–$25,000 annually for bug fixes, dependency updates, and minor feature work.
Cloud infrastructure scales with usage. Early-stage products often start at $50–$300/month on AWS, GCP, or Azure, but costs rise quickly with traffic, data storage, and added services.
Security is the most commonly skipped line item. Penetration testing, compliance audits, and vulnerability patching are not optional for products handling user data. Budget $2,000–$10,000 per year, depending on your compliance requirements.
Step 7: Add a Contingency Buffer
No estimate survives contact with a real project unchanged. A contingency buffer accounts for the unknowns you cannot price at the start: a third-party API that behaves differently than expected, a requirement that grows in scope mid-sprint, or a key developer who needs to be replaced.

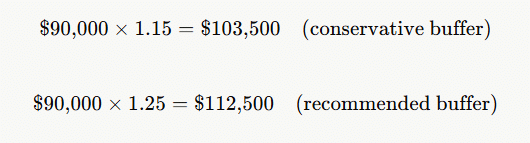

The standard range is 15–25% added on top of your total estimate. Using a $90,000 base estimate as a reference point, a buffer can present a range of $103,500–$112,500.

Present a range to stakeholders, not a single number. Ranges are honest. They signal that you understand how software projects work, and protect the budget when reality diverges from the plan.
Software Development Costs in North America (2026)
North American development rates are among the highest in the world. A mid-level developer in the US or Canada typically bills at $50–$100/hr, compared to $25–$50/hr in Latin America and $30–$60/hr in Eastern Europe. The quality gap between these regions has narrowed considerably over the past decade, which is why more companies are building hybrid or fully remote teams rather than staffing exclusively onshore.
Project Size and Cost Ranges
The average cost for a custom app in North America has reached approximately $171,000 in 2026. Here is how costs break down by project type.
| Project Size | Description | North America Cost Range |
| Simple / MVP | Basic mobile or web app, proof of concept, limited integrations. No-code/low-code can reduce this further. | $5,000 – $50,000 |
| Mid-Sized Application | Consumer app or SaaS platform with user accounts, payment processing, and custom UI. | $50,000 – $150,000 |
| Complex / Enterprise | Multi-platform systems, enterprise backends, AI/ML features, or high-security requirements. | $100,000 – $300,000+ |
Average Hourly Rates by Role in North America (2026)
These figures reflect mid-level talent. Rates rise with seniority and narrow when hiring through distributed or remote models.
| Role | Average Rate (USD/hr) | Typical Range (USD/hr) |
| Front-End Developer | ~$50 | $40 – $80+ |
| Back-End Developer | ~$55–$60 | $50 – $100+ |
| Full-Stack Developer | ~$60 | $55 – $100+ |
| DevOps Engineer | ~$60 | $50 – $80+ |
| Project Manager | ~$48–$50 | $40 – $60 |
| QA Engineer | ~$48–$50 | $30 – $50+ |
Monthly Burn Rate by Team Size
Monthly burn rate is the clearest way to understand what a team actually costs while the project is running. In North America, even a lean team adds up fast.
| Team Size & Project Type | Typical Composition | Monthly Burn Rate (USD) |
| Small (MVP / Simple App) | 2–3 Developers, 1 QA Engineer, Part-time PM | $20,000 – $40,000 |
| Mid-Sized (Custom App) | 5–8 Members (Developers, DevOps, QA, UI/UX, PM) | $50,000+ |
| Large (Enterprise Platform) | 15–20+ Members across specialized roles | $100,000+ |
A six-month mid-sized project with a standard team composition can exceed $300,000 in North America before post-launch costs are factored in.
How Region Affects What You Pay
| Region | Monthly Developer Rate (Mid-Level) | Time Zone Overlap with the US | DistantJob Coverage |
| North America | $8,000 – $15,000 | Full overlap | Available |
| Latin America (Nearshore) | $4,000 – $8,000 | Full to partial overlap | Available |
| Eastern Europe (Offshore) | $4,500 – $9,000 | Partial overlap (4–6 hrs) | Available |
What This Means for Your Budget
If North American rates are pushing your project out of reach, the issue is usually not the project; it is where the team is located. Companies that shift to nearshore or offshore hiring through a vetted remote model typically see a 40–50% reduction in monthly burn rate, without rebuilding the team from scratch or accepting slower delivery.
These savings are not about “finding cheaper developers”. It is about accessing the same or higher seniority levels at market rates that reflect where those developers live, not where your office is.
Latin American developers working in your time zone with strong English communication skills are a practical option, not a compromise. The same applies to Eastern European engineers for teams willing to structure async workflows around a 4–6 hour overlap window.
5 Ways to Reduce Software Development Costs (Without Cutting Quality)
At DistantJob, this is the model we help companies build: remote teams that match the technical role requirements, fit the company culture, and reduce costs while increasing delivery quality.
1. Start with an MVP
Building everything at once is one of the most reliable ways to overspend. A Minimum Viable Product ships the core functionality first, for $5,000–$50,000, and lets real user behavior guide what gets built next. A full-featured build launched without that feedback loop often runs $150,000 or more, with a third of those features going unused. Validate before you scale.
2. Hire Nearshore or Offshore Developers
Developer rates in Latin America and Eastern Europe run 40–60% lower than equivalent North American rates, not because the talent pool is weaker, but because the cost of living in those markets is different. A senior full-stack developer in Brazil or Poland brings the same technical depth as one in New York at a fraction of the monthly burn. The key is hiring through a process that screens for communication skills and remote readiness, not just technical output.
3. Use Open-Source Libraries and Third-Party APIs
You do not need to build payment processing, authentication, or real-time data infrastructure from scratch. Stripe handles payments. Auth0 manages user authentication. Firebase covers real-time databases and hosting. Each of these integrates in days, not weeks, and costs a fraction of custom development. Leaning on established tools for non-differentiating functionality frees your team to focus budget on the parts of the product that actually set it apart.
4. Adopt Agile and Review Costs Each Sprint
McKinsey research shows that Agile teams complete projects 30% more efficiently than those using traditional delivery models. Short sprints force regular scope reviews, which catch budget drift before it compounds.
Reviewing cost and progress every two weeks means a requirement change in week four gets caught and priced in week four, not discovered at final delivery when rework is expensive.
5. Invest in QA Early
Bugs found during development cost 3–5x less to fix than bugs found after launch. That gap widens further if the issue reaches production and affects real users. QA is not a phase that happens at the end of the project. It is a continuous activity that runs alongside development from the first sprint. Teams that treat testing as a line item to trim at the end of the budget almost always pay more in total.
Conclusion
At this point, you have two decisions that shape everything else: the software architecture you are building and where your team is located.
Get those two things right, and the rest of the estimate falls into place.
Get them wrong, and no formula or contingency buffer will save the budget.
If your current numbers are not working, the fastest lever is team location. Most CTOs and founders who move to a remote model with vetted senior developers reduce their monthly burn rate by 40–50%, without extending timelines or reducing the technical quality of the output.
At DistantJob, we place senior remote developers within two weeks, matched to your stack, your working hours, and your team culture.
If you want to talk through your scope and get a realistic cost range, book a discovery call with us.
